Georgetown —
← All work

15 / 15 — Job-costing app · Software Private demo

SiteBook by BillBook

Job costing and site records for contractors

ClientBillBook
Year2026
ScopeProduct + build

A working private demo on sample data — shown to contractors one access code at a time.

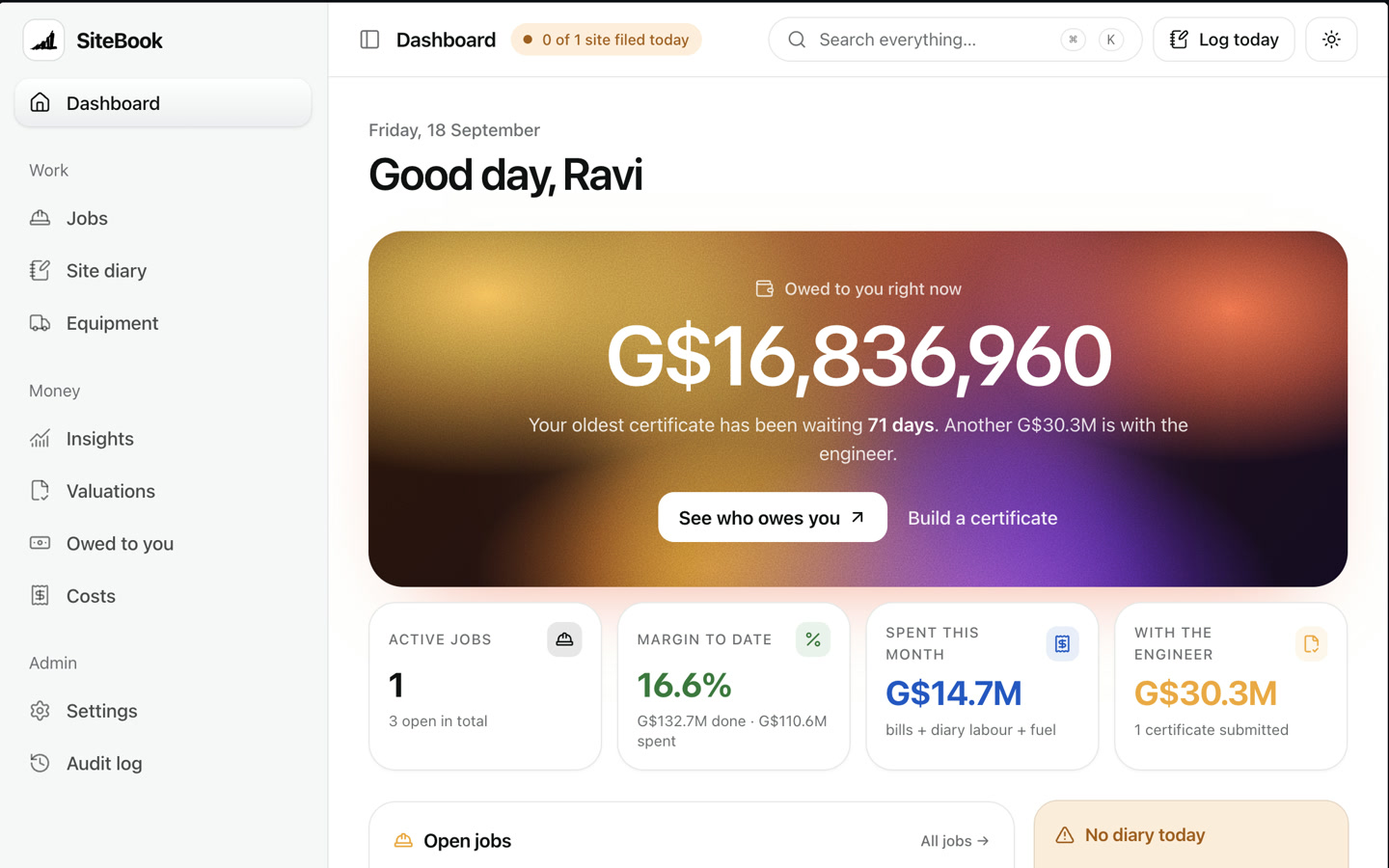

SiteBook by BillBook — the app itself

BillBook's second product, built for one industry: construction. Every job's valuations, costs and site diary live in one place — and the first thing a contractor sees each morning is how much they're owed, and by whom.

What we built

  • A morning dashboard: money owed, margin and spend at a glance
  • Jobs, BOQ and site diary for every project, plus one equipment list across all sites
  • Payment certificates built straight from the diary

The standout

The foreman's diary builds the payment certificate

Each day the foreman logs the work done against the BOQ from a phone. SiteBook adds it up into the next interim payment certificate, works out retention and advance recovery, and prints it on A4 ready for the engineer to sign.

How it worksDrawn the way we sketched it first
  1. 01 · LogThe foreman's diary, on a phone
  2. 02 · CostLabour + fuel fill themselves in
  3. 03 · WatchMargin, missed diaries, fuel
  4. 04 · ValueValuation to any date, pre-filled
  5. 05 · CertifyPrint the IPC, engineer signs
  6. 06 · Collect“Owed to you” until it's paid

circled — the part that makes it worth building

Inside the app

Screen by screen — what each part does.

Real screens from the working product, with the job each one does for the business.

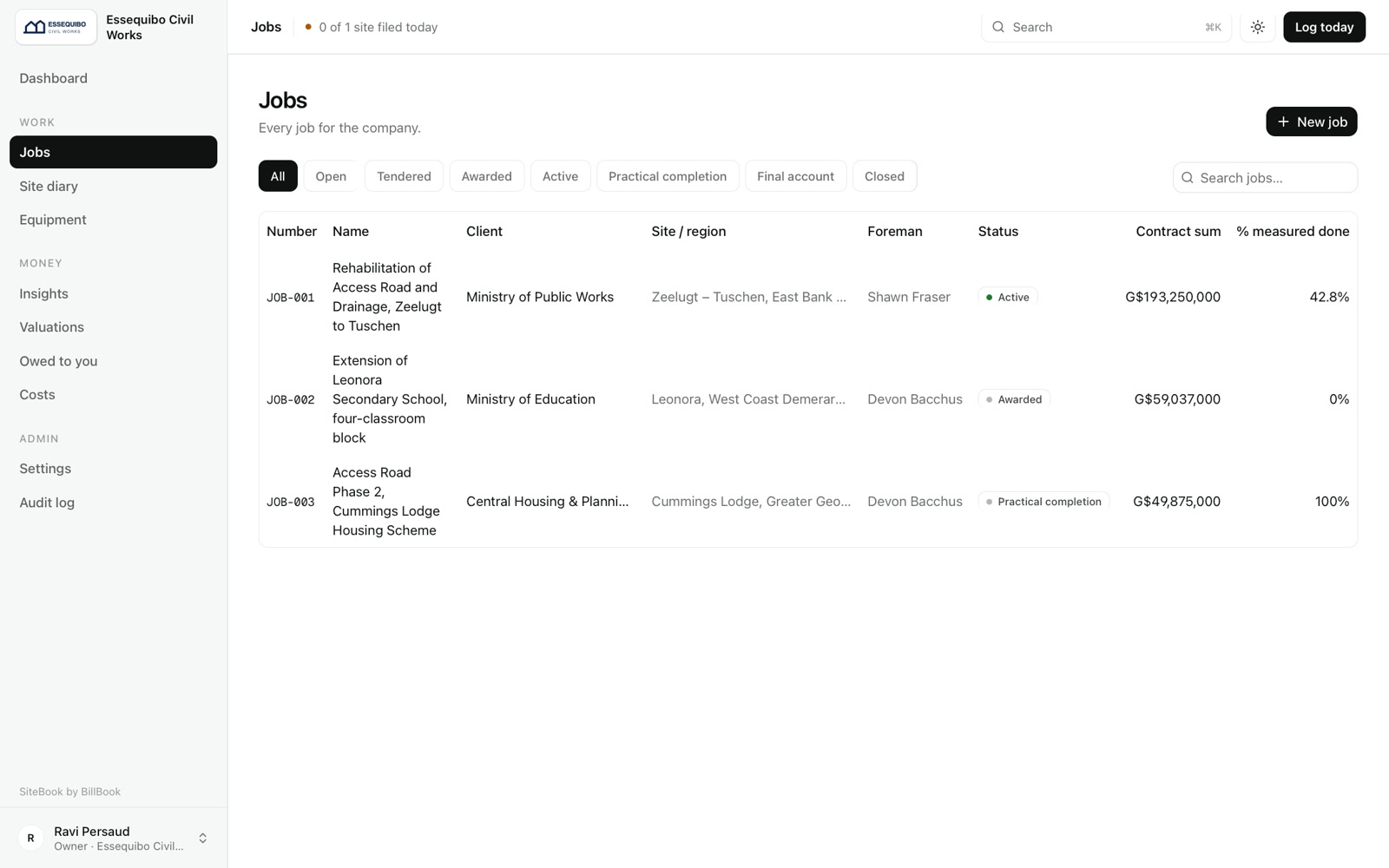

Jobs

Every job for the company

Client, site, foreman, contract sum and how much has been measured as done — tendered, awarded, active or closed.

SiteBook by BillBook: Every job for the company

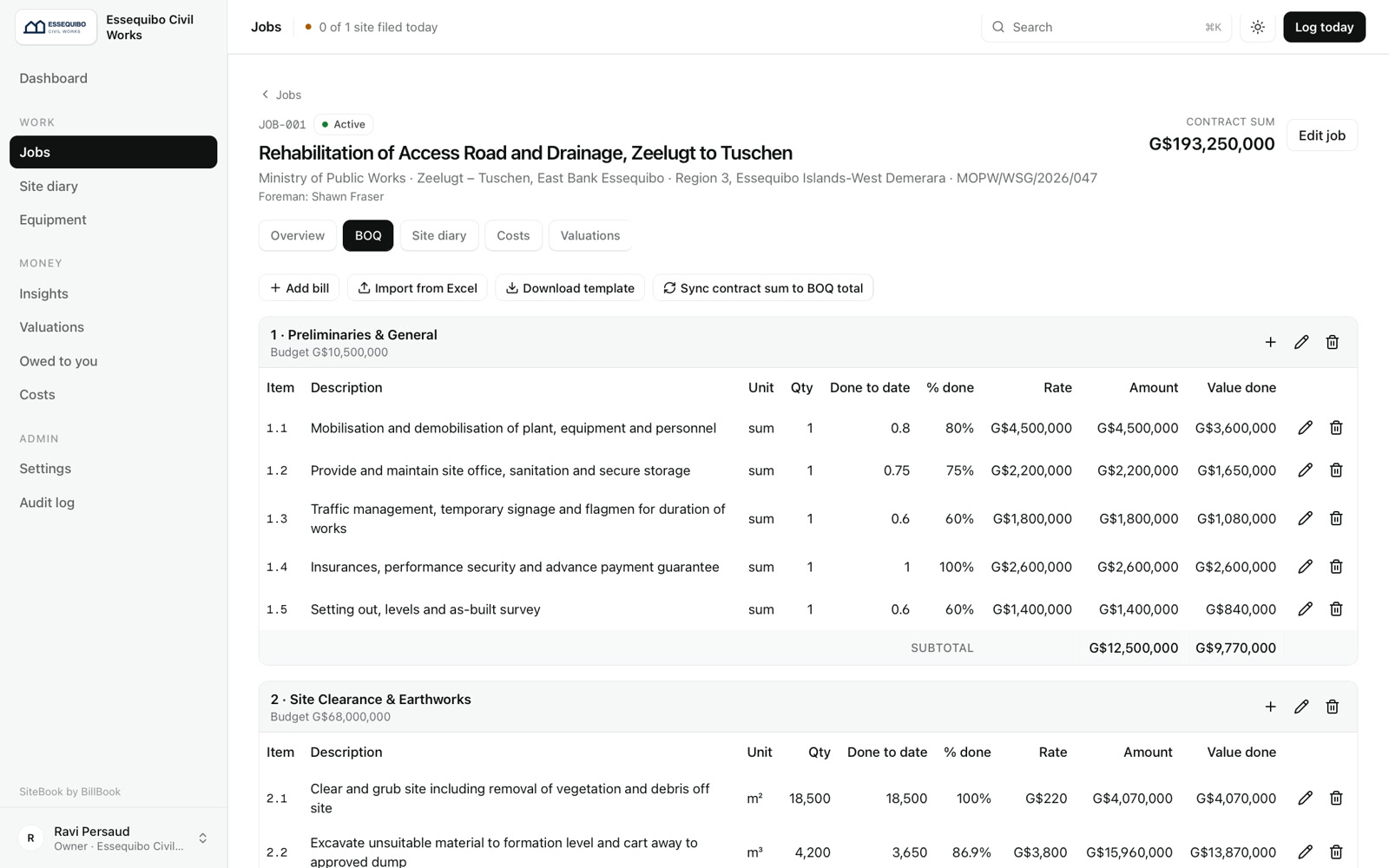

BOQ

The bill of quantities, alive

Imported from the tender's Excel file. Quantity done to date and value done update from the site diary, line by line.

Rates and amounts never reach a foreman's screen.

SiteBook by BillBook: The bill of quantities, alive

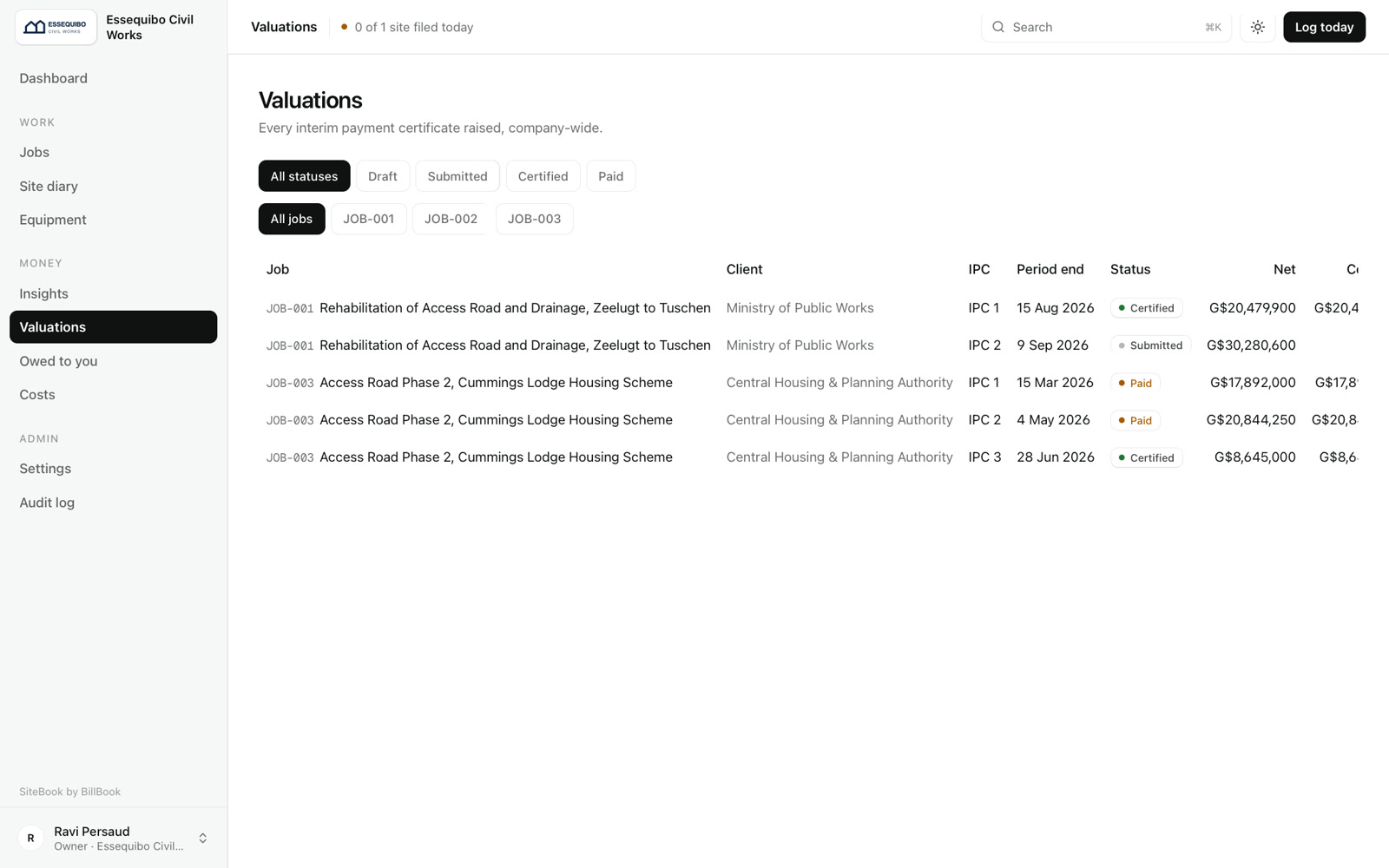

Valuations

Every certificate, every stage

Each interim payment certificate from draft to submitted, certified and paid, across every job.

SiteBook by BillBook: Every certificate, every stage

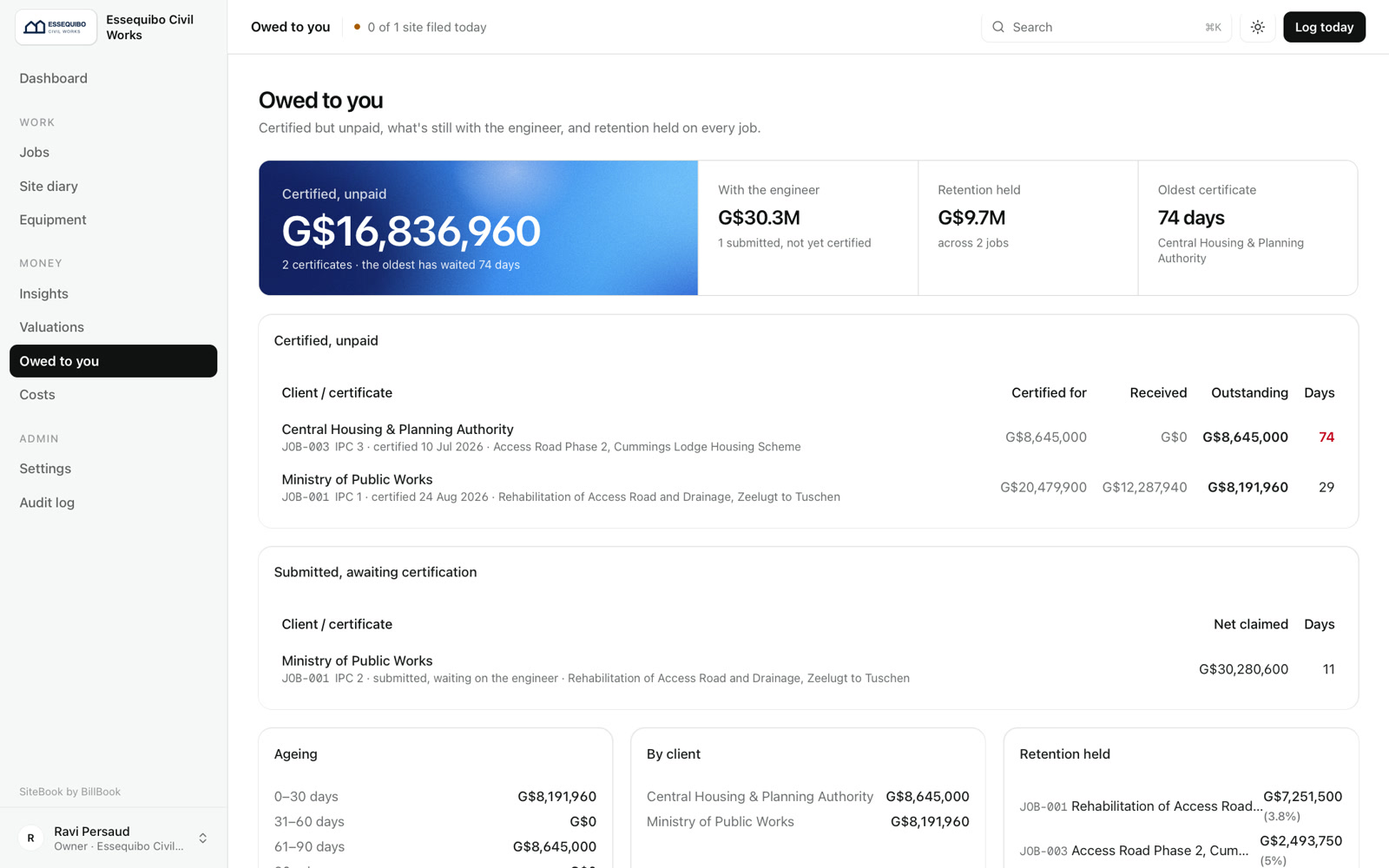

Owed to you

Who owes you, and for how long

Certified but unpaid, what's still with the engineer, and retention held — anything over 45 days shows in red.

SiteBook by BillBook: Who owes you, and for how long

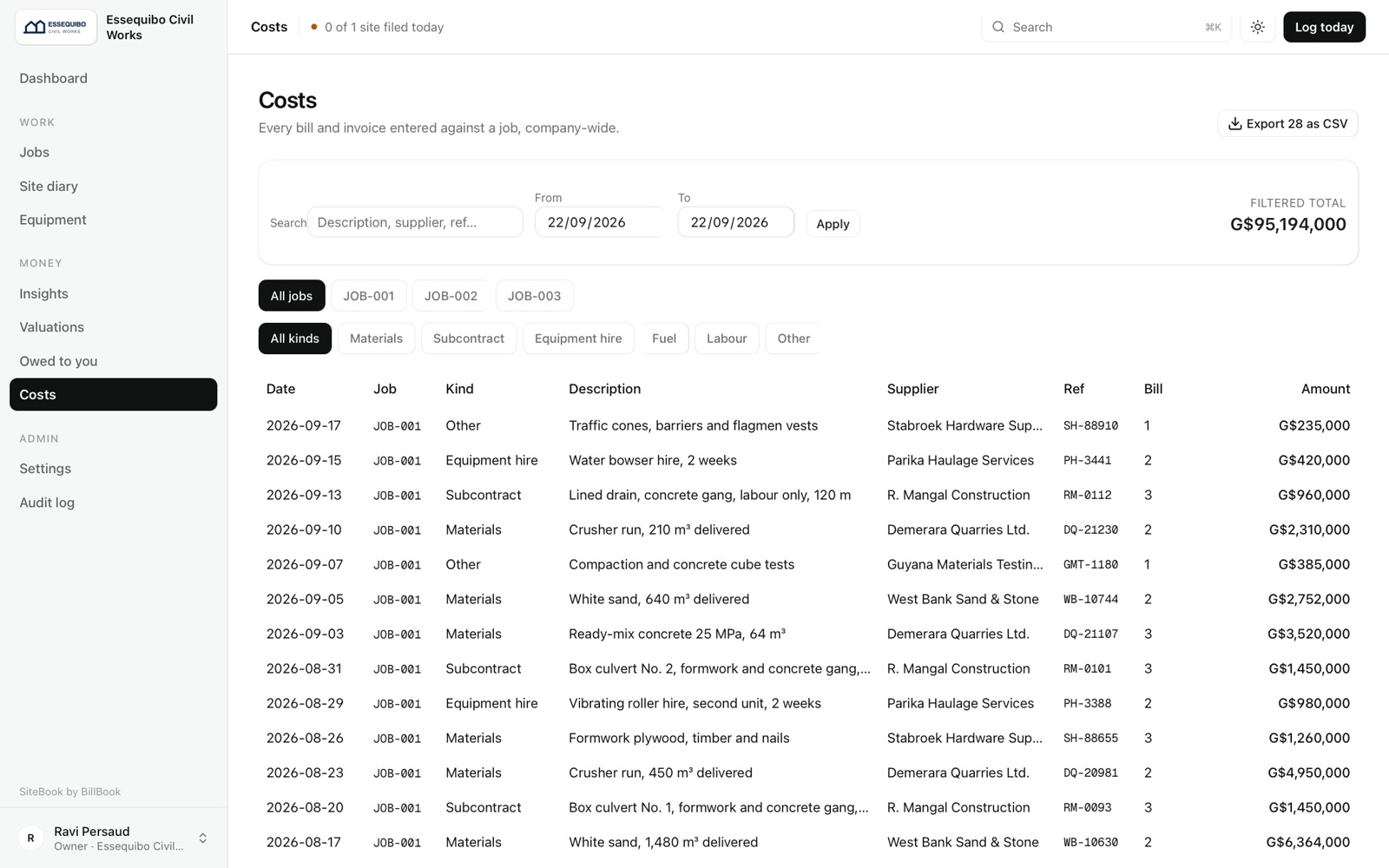

Costs

Every bill against a job

Materials, subcontract, equipment hire, fuel and labour, filtered by job and kind, and exported to CSV.

SiteBook by BillBook: Every bill against a job
On a phoneThree screens from the app — scroll inside any of themSwipe for more →

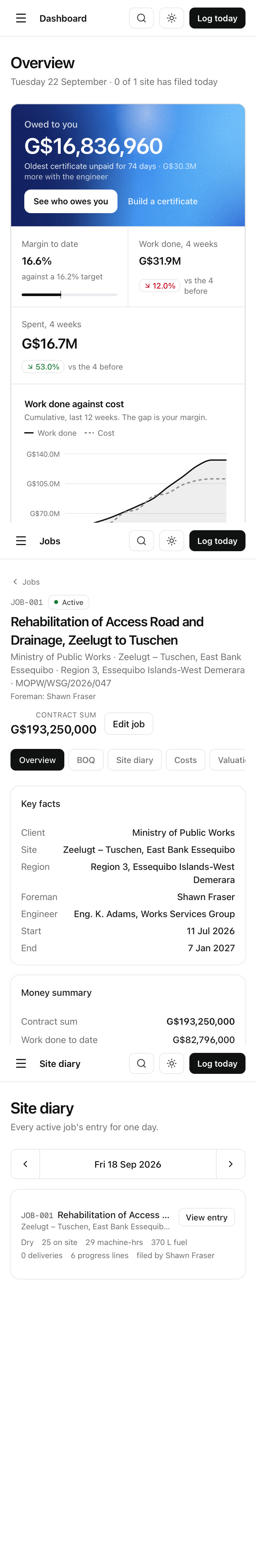

SiteBook by BillBook on a phone — dashboard
Dashboard
SiteBook by BillBook on a phone — a job
A job
SiteBook by BillBook on a phone — site diary
Site diary

The breakdown

Everything it does, for the people using it.

11 things this product handles — most of them invisible until you need them.

What the team does in it

  • A phone-first site diary

    Weather, stoppages, headcount by trade, machine hours, fuel, delivery photos and quantities done — and “Same as yesterday” fills the crew in one tap.

  • Jobs and BOQ from Excel

    Each job's contract sum, client, engineer, retention and target margin. The tender BOQ imports straight from Excel, even the messy ones.

  • Valuations and printed certificates

    Draft, submitted, certified, paid — and an A4 certificate with your logo, the amount in words and three signature lines.

  • “Owed to you”

    Every certified-but-unpaid certificate with its days outstanding, totals by client, and retention held.

  • An equipment fuel check

    A machine burning more than 25% over its expected litres an hour jumps to the top, with the extra diesel in litres and dollars.

What it handles for them

  • Costs that fill themselves in

    Labour from diary headcount times day rates; fuel from litres times the fuel price. Supplier bills are checked against each BOQ section's budget.

  • Money hidden by role

    Six roles. Foremen are never sent a rate, cost or margin — the server leaves them out, not just the screen.

  • Retention and advance rules

    10% retention, capped at 5% of the contract; the advance recovered at 20% of each period — set per company, changeable per job.

  • An audit log

    Every important change recorded with who made it and when.

  • Companies kept apart

    Each contractor's data is walled off from every other company's.

  • A private hosted demo

    One access code per prospect, their firm's name watermarked on screen, and fresh sample data every night.
